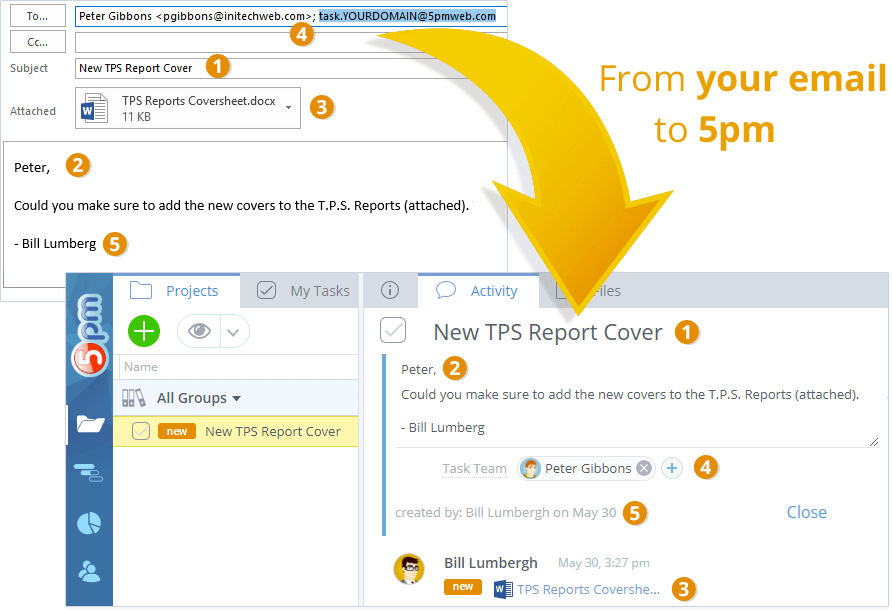

Besides the Email Notifications sent by 5pm to user's email accounts, an email-to-5pm communication is also possible. Tasks, Messages and Progress Notes can be created and updated directly from emails.
You can use an existing email to create a new 5pm task from it.
The new Task will appear in your 5pm account within a few minutes. The following rules will apply:
The Subject line can also include additional parameters included in square brackets after the task name. Here is the syntax for a Subject line that includes all those parameters:
These parameters are optional and can be included in any order, except the first one( [ProjectName]). Here is the full description of each:
[Project Name] |
This parameter should always follow first, right after the main subject part (Task name). It should
contain the full name or just the first letters/words of an existing project. When this
parameter is present, the following will happen:
Examples of usage:
|
[start: date] or [startdate: date] |
This parameter is used to define the Task's Start Date. The date following the "start:"
(or, the alternative spelling "startdate:") keyword should follow these formatting
rules:
Date format (in email subjects).
If Start Date parameter is not passed, the Task is set to start on the day the email was sent.
Dates should be in the mm/dd/yy or dd/mm/yy format, depending on the settings in the sender's 5pm account (users can switch between US and EU formats through the "settings" link on the top of 5pm screen). Alternative date formats are also accepted: mm-dd-yyyy and mm.dd.yyyy. You can also use 2 or 4-digits for the year — both will work. Examples of valid dates: 01/01/08, 01/02/2008, 01.01.2008, 01-01-2008, 01-01-08... Examples of usage:
|
[end: date] or [deadline: date] or [enddate: date] | This parameter is used to define the Task's Deadline ( "end:", "deadline:" and "enddate" are alternative spellings). The same rules apply as with the "Start Date" parameter. If the Deadline is not defined, it will be left empty in the newly created task. |
[Estimated time] or [Estimated hours] or [Estimated] |
Estimated Hours is the number of hours it would/should take the task to complete.
Example of usage:
|
[hide] or [hidden] | This keyword, when included in the subject line between square brackets, will hide the newly created Task from non-team members. |
[notify task team], [notify task] or [NotifyTaskTeam] | This keyword, when included in the subject line between square brackets, will send an email notification to the Task Team. |
[notify project team] ,[notify project] or [NotifyProjectTeam] | Same as "notify task team", but sends an email notification to the parent Project Team. |
[group: groupName] | Applies only to Single Tasks (tasks outside projects) and defines to what group the task should belong to. If a group with such name is not found, the Task is not added to any groups. If the parent project is indicated for the task, the task will belong to the project, and its group will be defined by that project's group. |
[Open] [On Hold] [Done] |
These keywords (just one of them to be used at a time) when included in the subject line between square brackets, will set the Task's Status as "Open", "On Hold" or "Done" respectively. |
[Low] [Normal] [High] [Urgent] |
These keyword (just one of them to be used at a time) when included in the subject line between square brackets, will set the Task's Priority as "Low", "Normal", "High" or "Urgent" respectively. |
If you send other emails to task.yourdomain@5pmweb.com with the same subject, which you used to create a Task from email (or if a task with such name already exists), instead of creating a new Task with the same name, the new emails will be added as Messages or Progress Notes to the existing Task. You can reply to the original email that created the Task, forward it and so on, but as long as you keep task.yourdomain@5pmweb.com in the receiver's list, those emails will also be adding Messages/Progress Notes to the original Task is 5pm.
The format for creating a Message is exactly the same as when creating a Task.
To create a Progress Note, all you have to do is just add a new parameter ([progress:]) at the end of the subject line (without modifying the rest of it) to indicate the completion % of the Task. You can also add another parameter — [time:] to report the time spent on the Task. Here is the full syntax for creating a Progress Note:
Email subject: Task Name [Project Name] [progress: 50%][time:4]
[progress: 50%] or [percent: 50%] | This parameter is mandatory if you want to add a Progress Note to an existing Task. If you skip it — a
simple Message will be created.
Example of usage:
|
[time: 5], [HoursDone: 5] or [hours: 5] |
You can also report the amount of hours spent on a task with a Progress Note.
Example of usage:
|
[hide from Client] or [internal] | This parameter can be added to Messages only (not Progress Notes). It will hide it from Clients.
Example of usage:
Note: When sending an email notification about a message added to 5pm, if that message is hidden from clients, the email notification will already contain the "[internal]" flag in the subject line, so the reply to that email will create messages hidden from clients as well (unless you modify the email subject, removing that flag). |
Any attachments from those emails will be added as Files to the Task.
You can not change other task parameters, as Priority and Status, by adding those parameters to Messages or Progress Notes emails. Those parameters can only be set when creating the new tasks.
Messages can also be added directly to Projects, if you skip the task name and only include the project name in square brackets.
